Blueprint library/Deviation

GxP Deviation & Investigation Management Software

Event to containment. Evidence to cause. Product impact to effective action. No ‘human error’ dead ends.

Capture manufacturing, laboratory, facility, equipment and data deviations with live context; control containment and notifications; classify and scope impact; plan and execute evidence-based investigations; test hypotheses and recurrence; approve root cause and product decisions; connect CAPAs and changes; verify effectiveness; trend systemic signals; and close with complete rationale.

GxP Deviation & Investigation Management Software

A deviation record should explain what departed from expectation, what was done immediately, which product and evidence may be affected, how the investigation tested possible causes, why the final cause and impact conclusions are credible, and whether the response prevented recurrence.

Seal connects the event to contemporaneous manufacturing, laboratory, facility, equipment, material, environmental, training, access, and audit-trail context. It supports investigation judgment without substituting generated text for evidence.

Detection preserves the first facts

Reporter or automated source, date, time, location, process, batch, sample, instrument, system, observed condition, expected condition, alarm, values, photographs, files, witnesses, and immediate risk are captured before later interpretation changes the story.

Immediate action controls the present risk

Stop, pause, isolate, label, hold, secure data, preserve samples, notify, transfer, inspect, correct a safe condition, or continue under authorized control records actor, time, reason, verification, affected items, and expiry.

Containment is not root cause and does not close the event.

Deviation control / first 12 minutes
Preserve the facts while containing the risk
clock running
T+00m14:06
MES
Excursion detected
pH 7.42 / limit 7.30
T+04m14:09
Operator
Process paused
Hold step frozen safely
T+08m14:12
Warehouse
Population held
Batch + linked pool blocked
T+12m14:18
Quality
Containment verified
Owner, evidence, expiry set
FACTS FROZEN
actual value · alarm · recipe v12 · actor
RISK BOUNDED
batch B26084 · pool P-19 · no distribution
CONTROL EXPIRES
18:00 unless Quality renews with rationale
Fig. 1 / A deviation controlled from detection through verified, expiring containment while contemporaneous facts remain preserved

Classification drives proportional control

Deviation type, source, GxP impact, sterility or patient risk, data integrity, product state, recurrence, detectability, regulatory or supply consequence, preliminary severity, investigation level, due date, escalation, and approvers define classification.

Later evidence can change the classification with a retained rationale.

Classification is a controlled decision
Evidence sets the investigation depth, clock, and expertise
preliminary
Risk evidence
Patient / productPotential
Sterility assuranceNone seen
Data integritySource intact
Recurrence2 similar / 12 mo
DetectabilityAfter the step
Decision / QA
MAJOR
Approved 14:31 · rationale retained
New evidence can reclassify up or down—never silently.
Control package
Investigation
Level 2 / full RCA
Due
10 business days
Expertise
QA · Process Eng · QC
Approval
Quality Unit
Escalation rule
Confirmed distributed-product impact → critical review within 2 hours
Fig. 2 / Risk evidence driving an approved deviation classification, investigation depth, due date, expertise, and escalation path

Chronology is assembled from attributable events

Process phases, system records, alarms, audit events, material movements, equipment states, samples, test actions, communications, shifts, interventions, decisions, and timestamps form one timeline.

Context is captured automatically where possible

Recipe and procedure versions, actual parameters, equipment calibration and maintenance, material lots, training and authorization, room and utility state, methods, instruments, sample custody, access, and related quality events attach to the deviation.

Attributable chronology / 14:02—14:18
Reconstruct the state that existed when the event occurred
sources verified
MES
phase + actuals
LIMS
samples + results
Asset
calibration + work
QMS
training + changes
Audit
identity + edits
Deviation chronologyDEV-014
14:02Hold phase beginsMES
14:06pH crosses action limitHistorian
14:09Operator pauses recipeeBR
14:11Probe check initiatedAsset
14:18Containment verifiedQMS
STATE
recipe v12 · probe FW 3.8 · CAL-882
PROVENANCE
source · version · timestamp · identity
LIMIT
historian gap 14:13—14:14 retained
The chronology is a reproducible view of source records—not a retrospective story typed into a form.
Fig. 3 / MES, LIMS, asset, quality, and audit records reconstructed into an attributable event chronology with provenance and known evidence limits

Impact assessment defines the affected universe

Product, batch, material, sample, equipment-use interval, process interval, room, line, campaign, result, report, stability study, distributed inventory, customer, study, market, data, and prior decision are identified through backward and forward traceability.

The assessment distinguishes potentially affected, assessed unaffected, confirmed affected, and unknown.

Backward + forward trace / IMPACT-DEV014-v04
Bound the affected population; explain every inclusion and exclusion
2 held
Source boundary
Probe P-440
use interval
CAL-882
last known good
Recipe v12
hold phase
Deviation interval
14:02—14:18
last-known-good → verified reset
01
affected
01
hold
02
excluded
Resolved population
B26083before intervalexcluded
B26084overlaps 14:02–14:18affected
POOL-19contains B26084hold
B26085after verified resetexcluded
Product decision
B26084 held for targeted testing; unaffected distributed stock remains released.
scope approved
Fig. 4 / Backward and forward traceability bounding the deviation interval and explaining the inclusion, exclusion, hold, and disposition of each affected item

The investigation plan states what must be tested

Problem statement, scope, team, expertise, hypotheses, evidence requests, interviews, experiments, sample or batch comparisons, timeline, dependencies, due dates, escalation, and approval define the plan.

Hypotheses remain visible even when rejected

Potential cause, mechanism, predicted evidence, supporting observations, contradicting observations, test, result, confidence, disposition, reviewer, and rationale remain part of the reasoning chain.

Investigation argument / INV-DEV014-v03
Competing mechanisms survive until the evidence resolves them
reviewed
Hypothesis / mechanism
Calibration
Lot compare
Audit trail
Shift pattern
Confidence
H1Probe drift
HIGH
H2Buffer variation
REJECTED
H3Technique
REJECTED
Direct cause
Probe bias during the hold interval
+
Systemic cause
Calibration frequency could not detect in-cycle drift
supports contradicts not discriminating
2 alternatives retained
Fig. 5 / Competing deviation hypotheses tested against supporting, contradicting, and non-discriminating evidence before direct and systemic causes are approved

Evidence remains attributable and bounded

Record source, version, date range, population, selection rule, file, checksum, observation, interview, experiment, calculation, reviewer, limitation, and conclusion define each evidence item.

Human performance is investigated as a system

Task design, procedure clarity, information availability, interface, tools, workload, staffing, supervision, environment, fatigue, experience, training transfer, competing goals, error recovery, and organizational conditions are evaluated when behavior contributed.

“Operator error” describes where failure appeared; it does not explain why the system allowed it.

Root cause preserves mechanism and confidence

Direct cause, contributing factors, systemic cause, causal mechanism, supporting and contradicting evidence, alternative causes, confidence, scope, reviewer challenge, approval, and relationship to the observed event define the conclusion.

Inconclusive investigations remain explicitly inconclusive with residual risk and next controls.

Recurrence changes the investigation question

Similar events, shared products, processes, equipment, materials, methods, people, shifts, sites, suppliers, failure modes, causes, actions, and time windows are compared using documented similarity rules.

Logging a deviation / AI surfaces the pattern
New deviation / you type
|
neil searched history / 6 similar matches
Recurring pattern / 18 months
5 of 6 tied to Tank ABV-4 / 4 of 6 at shift change
DEV-2025-034
14 mo ago
Tank ABV-4 / shift change
DEV-2025-091
11 mo ago
Tank ABV-4 / shift change
DEV-2025-157
9 mo ago
Tank ABV-7 / day shift
DEV-2025-208
7 mo ago
Tank ABV-4 / shift change
DEV-2026-012
3 mo ago
Tank ABV-4 / shift change
DEV-2026-047
last week
Tank ABV-4 / shift change
Investigation re-framed
Not "what happened to this batch" — "why does Tank ABV-4 keep drifting at shift change?"
Fig. 6 / A newly reported deviation matched against prior events to reveal recurring equipment and shift patterns

Product and data decisions cite the investigation

Release, hold, reject, rework, retest, resample, invalidate, correct, recall assessment, field action, report revision, or no impact records applicable requirements, evidence, uncertainty, risk, approvers, and affected population.

Corrective and preventive actions address the cause

Correction, CAPA, change, document revision, training, engineering control, maintenance, supplier action, monitoring, validation, data correction, or process improvement connects to the causal factor and expected outcome it addresses.

Extensions are risk decisions

Original due date, reason, work completed, work remaining, current risk, interim controls, product or data state, new date, owner, history, approvers, escalation, and limits define an extension.

Effectiveness tests recurrence and control performance

Cause, intended outcome, leading and lagging measures, population, observation period, sample, method, acceptance, evidence, recurrence, unintended consequences, reviewer, result, and follow-up define verification.

Cause → control → observed outcome
Closure is provisional until the action works in operation
reopen path tested
Systemic cause
Drift not detected within the calibration cycle
Engineered control
Automated reference check before every hold
Expected outcome
Bias found before material enters the risk interval
Leading measurepass
30/30
checks run
Lagging measurepass
0
recurrences / 90d
Acceptance met
Quality approves effectiveness and the deviation remains closed.
OR
Any criterion fails
Reopen the action, reassess cause and population, preserve the failed check.
Failure returns to the causal argument—not to a new, disconnected task.
Fig. 7 / A causal factor mapped to an engineered control, leading and lagging effectiveness measures, approval criteria, and a governed reopen path

Closure resolves every open branch

Approved event and impact, evidence, cause, corrections, product decisions, CAPA or change links, commitments, effectiveness plan, overdue work, communications, report corrections, signatures, retention, and reopen triggers define closure.

Type, site, area, process, product, equipment, material, supplier, method, cause, contributing factor, severity, age, recurrence, overdue state, CAPA and effectiveness support signal detection without flattening unlike events into one count.

Where Seal is strongest

Seal is strongest where deviations cross MES, LIMS, equipment, materials, training, audit trails, inventory, batch release, CAPA, change control, and regulatory evidence. It owns the investigation reasoning and impact decision while composing authoritative operational records.

Prove one difficult deviation end to end

The first implementation should follow an automatically detected process excursion through immediate containment, classification, full chronology, backward and forward impact, investigation plan, competing hypotheses, equipment and human-performance evidence, inconclusive first analysis, recurrence match, approved root cause, batch decision, CAPA, change, effectiveness failure, and reopened action.

Include a missing data interval, a trained operator, an in-calibration instrument later found biased, a material-lot difference, an overdue extension, and distributed product outside the affected interval. The system must show why the final scope and cause are defensible.

Operating model

The control layer sits above the systems that supply governed records and execution.
Control layer

Owned by this blueprint

Live state and point-of-use decisions

  • Event Capture, Containment & Escalation
  • Risk Classification & Investigation Plan
  • Competing Hypotheses & Root-Cause Argument
  • Affected Population & Product Decision
  • Recurrence & Systemic Signal
  • CAPA, Effectiveness & Reopen Control

Capabilities

01native controlEvent Capture, Containment & Escalation
Detect the event automatically or report it in context. Seal freezes the first facts, executes holds and notifications, verifies each immediate action, and makes temporary controls expire unless Quality deliberately renews them.
02native controlRisk Classification & Investigation Plan
Classification is an approved risk decision—not a dropdown. Patient, product, sterility, data-integrity, recurrence, and detectability evidence set the investigation level, clock, expertise, and escalation path.
03native controlCompeting Hypotheses & Root-Cause Argument
Investigators compare plausible mechanisms against predicted observations. Supporting and contradicting evidence, rejected alternatives, confidence, reviewer challenge, and direct and systemic causes remain in one inspectable argument.
Trace from the event interval backward to causal inputs and forward to batches, pools, inventory, reports, and markets. Every affected, held, unknown, or excluded item keeps the evidence and rule behind its status.
05native controlRecurrence & Systemic Signal
Search prior events with documented similarity rules, then review the source records behind each match. Seal separates a genuine recurring mechanism from superficial keyword similarity before escalation.
Map each correction and CAPA to the causal factor it addresses. Leading and lagging measures test whether the control works; a failed criterion reopens the causal branch with the original evidence intact.
Reconstruct the exact process, method, equipment, material, training, environment, and audit state at the time of the event. Known source gaps remain visible instead of being smoothed into a retrospective narrative.
Preserve original and derived records, identities, timestamps, changes, access, source files, and downstream use. Reviewers can see what changed, why it matters, and which reports or decisions relied on it.

Entities

Entity hierarchy
What it records
Kind
GxP Deviation
Observed and expected condition, source, context, risk, classification, owner, dates, and state.
entity
Manufacturing Process Deviation
Batch and operation event with process signals, materials, equipment, containment, and impact.
template
DEV-B26084-014
pH excursion during a bulk hold with a bounded equipment-use interval.
record
Immediate Action
Containment or safe correction, scope, actor, time, reason, verification, expiry, and state.
entity
Deviation Classification
Type, impact, severity, recurrence, investigation level, due date, escalation, and approval.
entity
Deviation Chronology
Attributed process, system, material, equipment, sample, communication, and decision events.
entity
Deviation Impact Assessment
Trace rule, population, potentially and confirmed affected items, evidence, uncertainty, and decision.
entity
Batch & Inventory Impact Assessment
Process interval, equipment usage, batches, pools, samples, inventory, distribution, evidence, and decision.
template
IMPACT-DEV014-v04
Two batches potentially affected; distributed inventory excluded by verified time boundary.
record
Investigation Plan
Problem, scope, team, hypotheses, evidence, interviews, experiments, dates, and approval.
entity
Cross-Functional Investigation
Manufacturing, engineering, QC and quality hypotheses, evidence, experiments, milestones, and reviews.
template
INV-DEV014-v03
Revised investigation plan after the first instrument check was inconclusive.
record
Investigation Hypothesis
Potential mechanism, predicted evidence, test, support, contradiction, result, confidence, and state.
entity
Investigation Evidence
Source, version, population, selection, observation, file, calculation, limitation, and review.
entity
Investigation Interview
Participant, role, timing, questions, responses, demonstrated evidence, review, and follow-up.
entity
Root Cause Conclusion
Direct, contributing and systemic causes, mechanism, alternatives, evidence, confidence, and approval.
entity
Evidence-Based Root Cause Analysis
Mechanism, direct and systemic causes, alternatives, support, contradictions, confidence, and approval.
template
RCA-DEV014-v02
Probe bias plus inadequate drift detection approved as combined causal mechanism.
record
Deviation Recurrence Assessment
Similarity rules, prior events, shared factors, patterns, prior actions, conclusion, and escalation.
entity
Deviation Product or Data Decision
Affected population, requirements, evidence, risk, disposition, corrections, approvers, and state.
entity

FAQ

It manages deviation detection, contemporaneous capture, containment, classification, chronology, contextual evidence, affected-population assessment, investigation plans, hypotheses, root cause, recurrence, product and data decisions, CAPAs, extensions, effectiveness, trends, approval and closure.

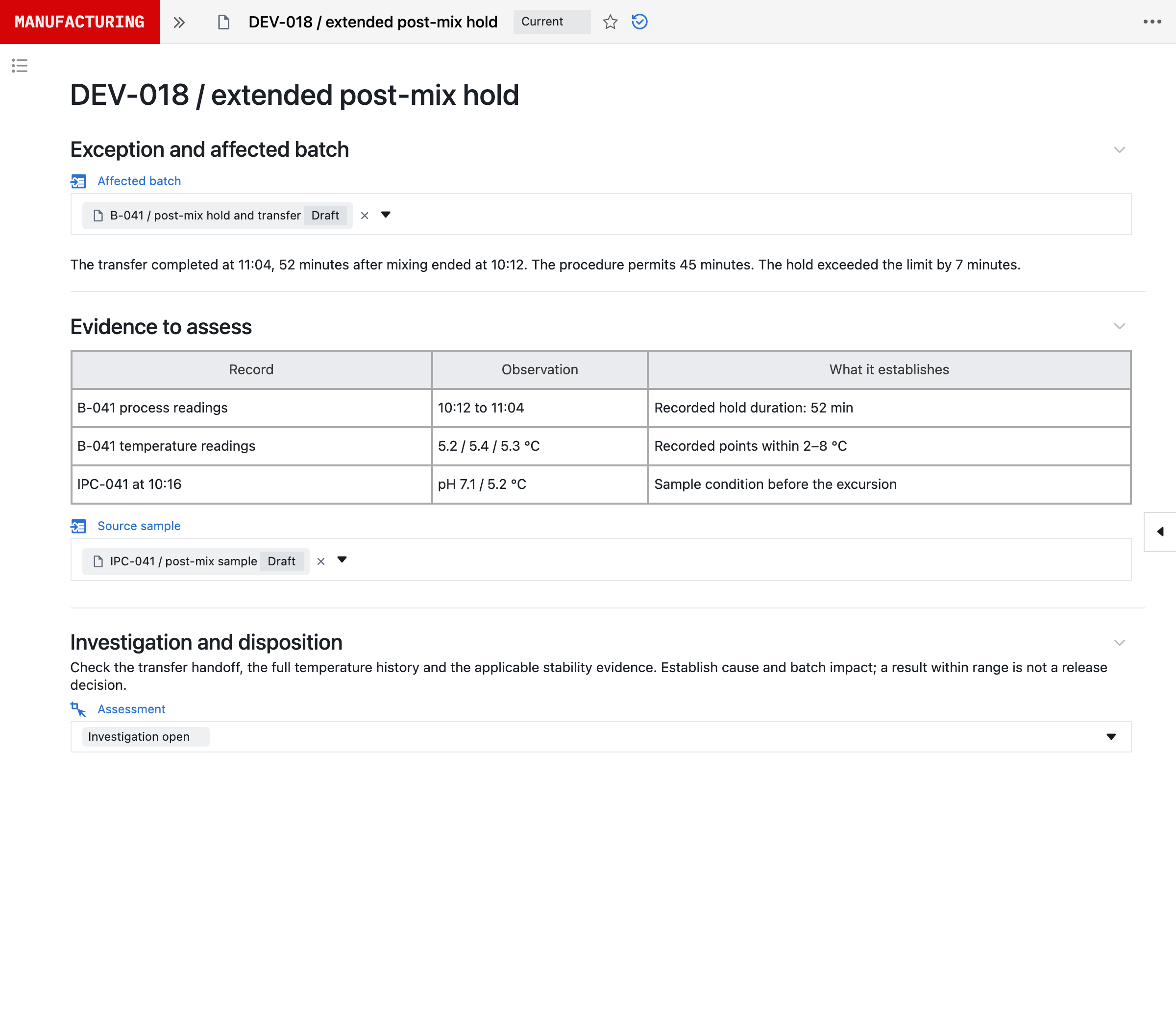

Yes. Equipment, environmental, process, laboratory or system events can create or propose deviations with objective values and source references. Authorized users confirm classification and add operational interpretation.
When behavior contributes, the investigation evaluates task design, procedures, interfaces, tools, workload, staffing, supervision, environment, fatigue, training transfer, competing goals and recovery controls before approving a causal conclusion.
Approved trace rules follow material, process, equipment-use, room, sample, result, data and inventory relationships backward and forward. Potentially affected, assessed unaffected, confirmed affected and unknown states remain distinct.
Yes. The record retains tested hypotheses, available and missing evidence, uncertainty, residual risk, interim controls, product decision, additional monitoring and approval rather than forcing an unsupported root cause.
Similarity can use failure mode, process, equipment, material, method, shift, site, supplier, cause, context and time. Proposed matches remain reviewable, and patterns link to exact prior events and actions.
Each extension retains the original date, reason, progress, remaining work, current product or data state, risk, interim controls, new date, history, approvals and escalation. Repeated extensions remain visible.
Approved causes and residual risks create actions tied to the expected outcome. CAPA, engineering, document, training, supplier, validation or change records retain the source deviation and return implementation and effectiveness evidence.
Configured gates require approved impact, cause or inconclusive rationale, product and data decisions, corrections, linked actions, commitments, extension status, effectiveness plan, required communications, signatures and no unresolved mandatory branch.
Prove one automated process excursion through containment, context, trace impact, competing hypotheses, equipment and human-performance evidence, recurrence, cause, batch decision, CAPA, change, failed effectiveness check and reopened action.

Related blueprints

PV

Pharmaceutical Process Validation & PPQ Software

Plan and execute process performance qualification, govern readiness and acceptance criteria, connect manufacturing and laboratory evidence, resolve deviations, calculate capability, approve validation conclusions, and hand the proven process into continued verification.

msat

MSAT Process Knowledge & Manufacturing Support Software

Run Manufacturing Science and Technology across process ownership, technology transfer, site and product knowledge, batch monitoring, process signals, investigations, change impact, validation and CPV, improvement, comparability, commitments, and governed manufacturing support.

Cleanroom Cleaning

Cleanroom Cleaning & Disinfection Management Software

Plan and execute cleanroom cleaning and disinfection by area and surface, control agent preparation and rotation, prove coverage and contact time, assess missed work, verify effectiveness, and govern return to use.

Stability

Pharmaceutical Stability Study Management Software

ICH-aligned and custom stability protocols, batches, packaging configurations, chambers, sample inventory, pull windows, chain of custody, testing, trends, statistical analyses, excursions, OOS and OOT, shelf-life proposals, commitments, annual placement, reports, and archive.

NC

GxP Nonconformance & Material Review Board Software

Material, component, product and process nonconformances with immediate segregation, affected-population trace, evaluation, MRB review, rework, repair, return, scrap, concession, execution, effectiveness, supplier linkage, and trending.

EM

Pharmaceutical Environmental Monitoring Software

Risk-based viable, nonviable, surface, personnel and utility monitoring with governed locations, schedules, production context, chain of custody, incubation, counts, identification, limits, trend rules, excursions, investigations, product impact, and program review.

Go live in 48 hours.
